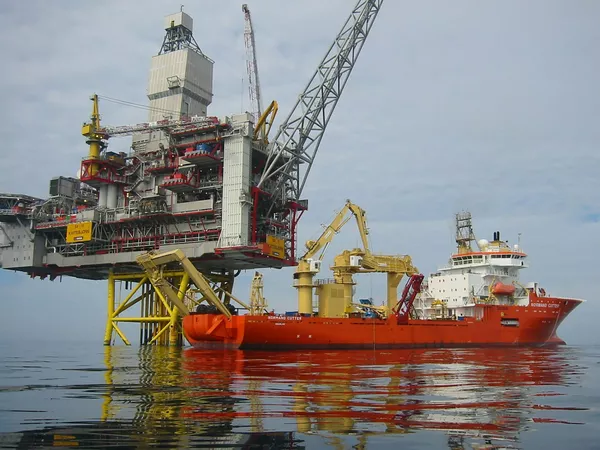

The converted Normand Cutter at work

Major conversion of the Normand Cutter

"The conversion of Normand Cutter has been a pilot project. The vessel has undergone an extensive conversion; though it was the time we had available which presented the biggest challenge. The whole job was completed in just over six months," says Project Manager Roar Riise of Ulstein Verft AS.
Published
16 July 2004
Share

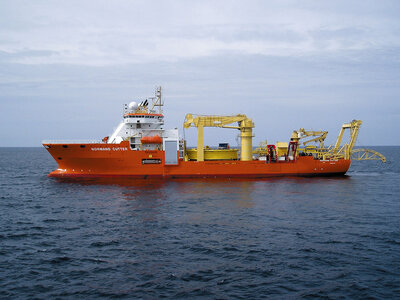

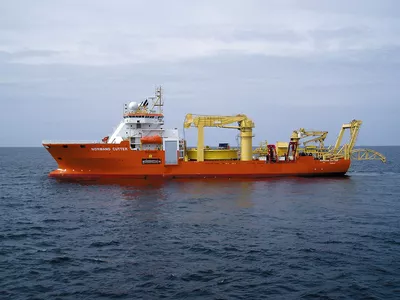

  • The converted Normand Cutter on survey at the Oseberg A field in June 2004.

  • The 'Normand Cutter' before conversion.

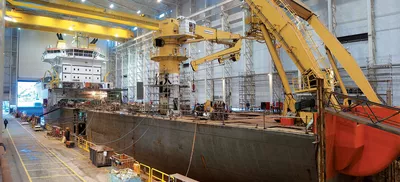

  • Normand Cutter in the dock hall in January 2004, about to be converted from a Cable Laying Vessel to a Pipe Laying and Construction Vessel.

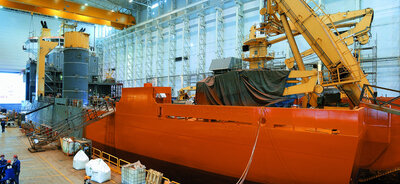

  • Normand Cutter in the dock hall in March 2004, two months after conversion commenced.
  • Project manager Roar Riise at Ulstein Verft supervised the conversion of the Normand Cutter.

On 5th December 2003 the cable-laying vessel Normand Cutter arrived at Ulstein Verft in Ulsteinvik, Norway. In May, some six months later, the new pipe-laying and construction vessel Normand Cutter left the shipyard. "Given what I know of our organisation, I had no doubt that we would get the job done. This extensive conversion was carried out in a very short time, thanks to the fantastic efforts made by everyone involved in the production, construction and project management," says Roar Riise.

A WHOLE "NEW" VESSEL

Normand Cutter underwent a metamorphosis: "No less than 1,300 tons of new steel were to be added to the vessel. Ulstein Verft's department in Vanylven, Norway, the Maritim Ltd. yard in Poland, and Salthammer Båtbyggeri in Vestnes, Norway, were engaged in constructing the steel sections to get the steel to Ulstein Verft quickly. The sections were used for the side tanks, base of the crane, new living module and ROV hangars," says Riise.

THE CRANE DOMINATES

"The most important part of the conversion was installing the 300 ton crane on the port side. It is an active heave compensating crane. A new distribution room that provides electricity for the crane was also installed," says the Project Manager. A 300 ton winch is connected to the crane below deck and the hydraulic generator for the crane, the so-called 'power pack', produces 4,400 kW. The 25 ton crane that was already installed in the vessel has been moved from the port side to the starboard side and upgraded with a new, larger winch. According to Normand Cutter's Captain, Geir Ove Olsen, the vessel now leans seven degrees when the largest crane is swung over the ship´s side.

"Side tanks, so-called compensators, were installed in the vessel to compensate for this. The vessel is now 3.6 metres wider from the stern to the bridge than it was before," says Superintendent Interior&Outfitting Marton Voldsund.

THE VESSEL HAD TO BE STRENGTHENED FOR DECK LOADS

One real challenge was the fore and aft strength: "With new requirements regarding extra deck loads, the load deck had to be strengthened to bear 10 tons per m2 for a total length of 60 metres. The basic hull was previously designed for 3 tons per m2. This job was demanding, partly because access was difficult. The main deck was strengthened and the distance between ribs halved, and the lower decks were also strengthened. The technical part of the work was solved with good help from Det Norske Veritas," says Johan Moldskred, Superintendent Hull&Steel Structure.

CAN CARRY OUT UNDERWATER OPERATIONS

A moon-pool, a well for underwater operations, has been introduced straight through the vessel. The vessel is classified for Dynamic Positioning, DYNPOS AUTR, and has powerful thrusters and motors in order to be able to perform DP-operations. "The DP controls have been moved to the aft bridge, and a new manoeuvring chair and controls have been installed in the aft bridge. Three new ROV stations have been installed: one on each side of the aftdeck and the third behind the bridge, where a separate hangar has been constructed," Marton Voldsund says.

CAROUSEL FOR UMBILICAL

Given the widening of the vessel there was room on deck for an extensive pipe carousel on deck with a capacity of 2,500 tons of pipes. "The carousel rotates at a speed of 600 metres per hour, and the umbilical is slowed down around the drum. The umbilical provides underwater platforms with everything they need," says the Captain. A pipeline that runs over the deck and back over the stern guides the umbilical into the sea.

ROOM FOR MORE PEOPLE ON BOARD

Normand Cutter can now take on a variety of demanding jobs, jobs that can require a lot of people. This meant there was a need to expand the on board living quarters. New living modules with cabins and offices were installed, and the vessel can now carry 114 people compared to the previous 70. New air conditioning also had to be installed due to this upgrading.

A PLEASURE BEING PROJECT MANAGER

All of this work took just six months: "There have been some minor delays along the way, but we have caught up again. It has been a pleasure being the Project Manager for this project group. Our employer, Solstad, has incredibly flexible, capable people at all levels, and I look forward to working with them on other projects in the future," says Roar Riise.

The sister vessel, 'Normand Clipper', went through a similar conversion at Ulstein Verft shortly after the 'Normand Cutter' project.
